burndown chart

How to create a Scrum burndown chart

Lucid Content Team

Reading time: about 7 min

According to the 14th Annual State of Agile Report, Scrum methodology remains the most popular Agile methodology, currently being used in 58% of companies that work in an Agile environment.

Scrum is popular because it is iterative, flexible, incremental, and adaptive. This framework lets the team manage itself, while still ensuring transparency and accountability with lots of communication, feedback, and continuous improvement. Each iteration is focused on delivering small, but valuable, product increments that will meet customer needs in the overall project.

In order to successfully deliver functioning product increments on a regular basis, Scrum requires that teams track and manage progress throughout the project—and the Scrum burndown chart is an effective tool to accomplish this.

Let’s discuss what a Scrum burndown chart is, how to set up and use one, and what benefits and disadvantages may occur when you use a burndown chart.

What is a burndown chart in Scrum?

A burndown chart is a graphical “information radiator” that shows the work that is planned to be completed in a sprint. In Agile, an information radiator is described as any handwritten, drawn, printed, or digital display that allows you to track progress on any project. It’s placed in a highly visible location so that people can get information at a glance.

Burndown charts let teams see how much work has been done, how much work is left to do, and how much time remains to complete the work. As tasks are completed, the graph “burns down” to zero on or before the last day of the time period.

Burndown charts are not required by Agile or Scrum, but they are useful tools that satisfy the requirement to monitor and manage progress and to provide transparency. Many Scrum teams like to use burndown charts because they are easy to set up and manage, and the information they provide is easy for team members and other stakeholders to understand and digest.

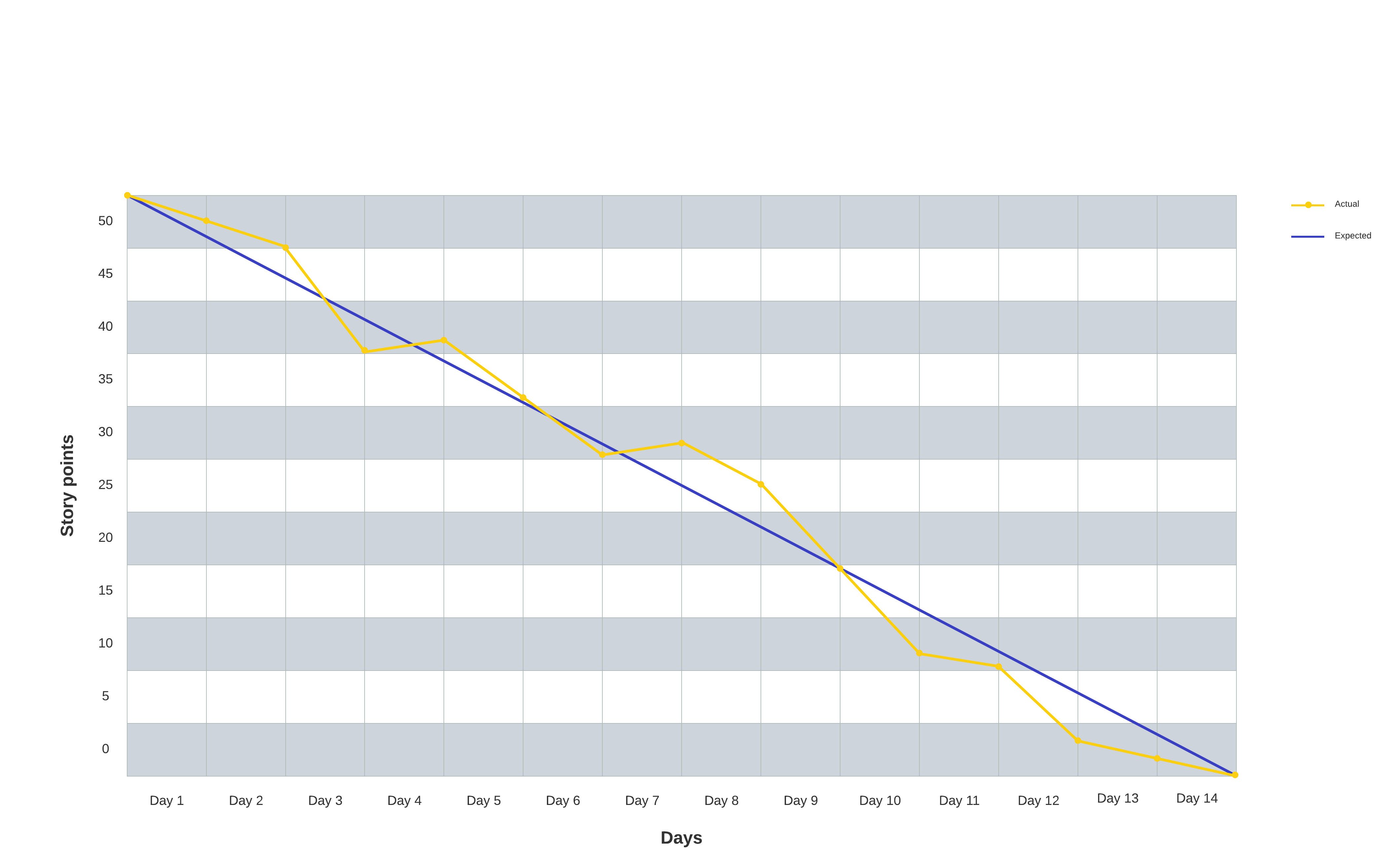

scrum burndown chart
Daily burndown chart example (Click on image to modify online)

4 steps to create a sprint burndown chart

Let’s review the elements of this Agile tool and the steps it takes to put a Scrum burndown chart together.

Step 1: Estimate work

The burndown chart displays the work remaining to be completed in a specified time period. The team looks at the backlog to determine what work needs to be done and estimate how much work can be completed.

  • Draw a vertical line to the left of your canvas to represent the work remaining to be done. The work remaining can be measured in story points, tasks, etc.

Step 2: Estimate remaining time

The team determines what work needs to be done and estimates how long it will take to complete each task.

  • Draw a horizontal line at the bottom of the canvas to represent the time remaining. Time can be measured in days, hours, sprints, etc. Plot the time units on the horizontal line.

Step 3: Estimate ideal effort

The ideal effort represents what the burndown chart will look like if the estimated work is completed on time.

  • Mark a starting point near the top of the vertical work remaining line. The starting point is represented by the total sum of the estimated work to be completed. For example, if the team estimates that they will complete 200 story points, the number 200 is placed at the top of the vertical axis.
  • Mark a finishing point to the right of the horizontal time remaining line, representing the point where all work is estimated to be completed.
  • Draw a straight diagonal line from the starting point to the finishing point to represent the ideal “burndown” slope if the work is completed on time.

Step 4: Track daily progress

Each day, the team updates and plots the progress against the work remaining. These updates represent the actual effort compared to the ideal effort.

  • Mark the points on the chart where work is actually completed.

Ideally, the actual effort would line up with the ideal effort. In reality, some work will be marked below the ideal effort line (indicating that the team is ahead of schedule), and other work will be marked above the line (indicating that the team is behind schedule).

The following example burndown chart gives you an idea of how your chart might look.

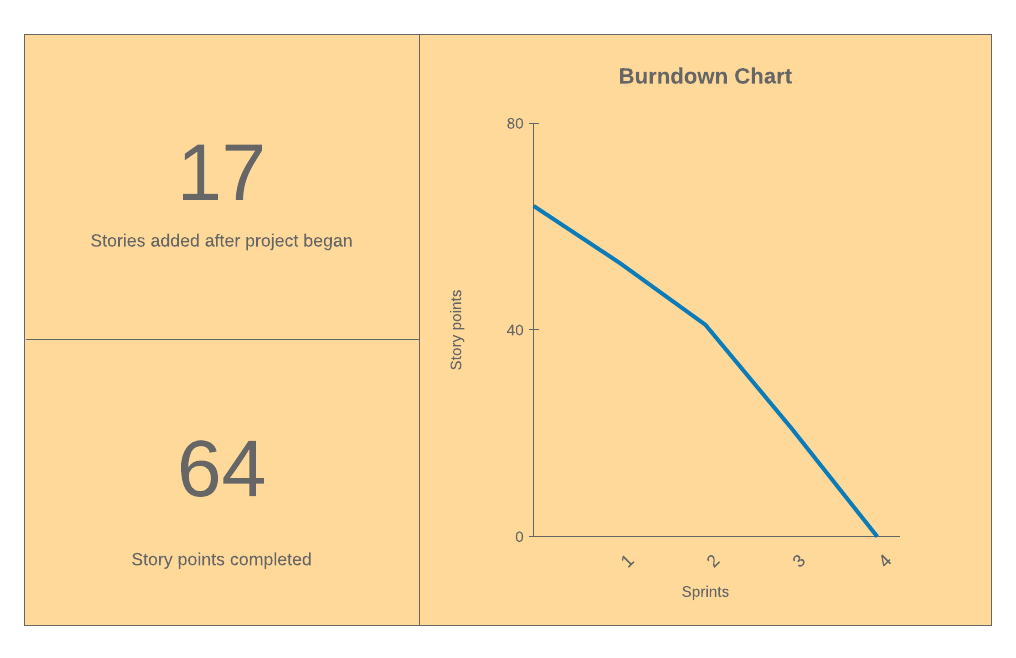

scrum burndown chart
Iteration burndown chart example (Click on image to modify online)

No matter what your sprint burndown chart ends up looking like, the important thing is that team members should be able to look at it and instantly see the progress and understand what still needs to be done to reach a goal.

Who creates and manages the sprint burndown chart?

Because Scrum is designed for smaller teams that are self managing, all members of the team (developers, product owner, Scrum master) are responsible for creating and updating a Scrum burndown chart.

The developers are responsible for making the information transparent so that stakeholders can keep up to date on the project’s progress. Looking at the estimated work line against the actual work line, the product owner determines if the project is on schedule or behind schedule. If the project is too far behind schedule, the product owner may decide to update the release plan in order to get the project back on schedule. The Scrum master’s role is to support and coach the team to ensure that they work within the rules set by agile and scrum.

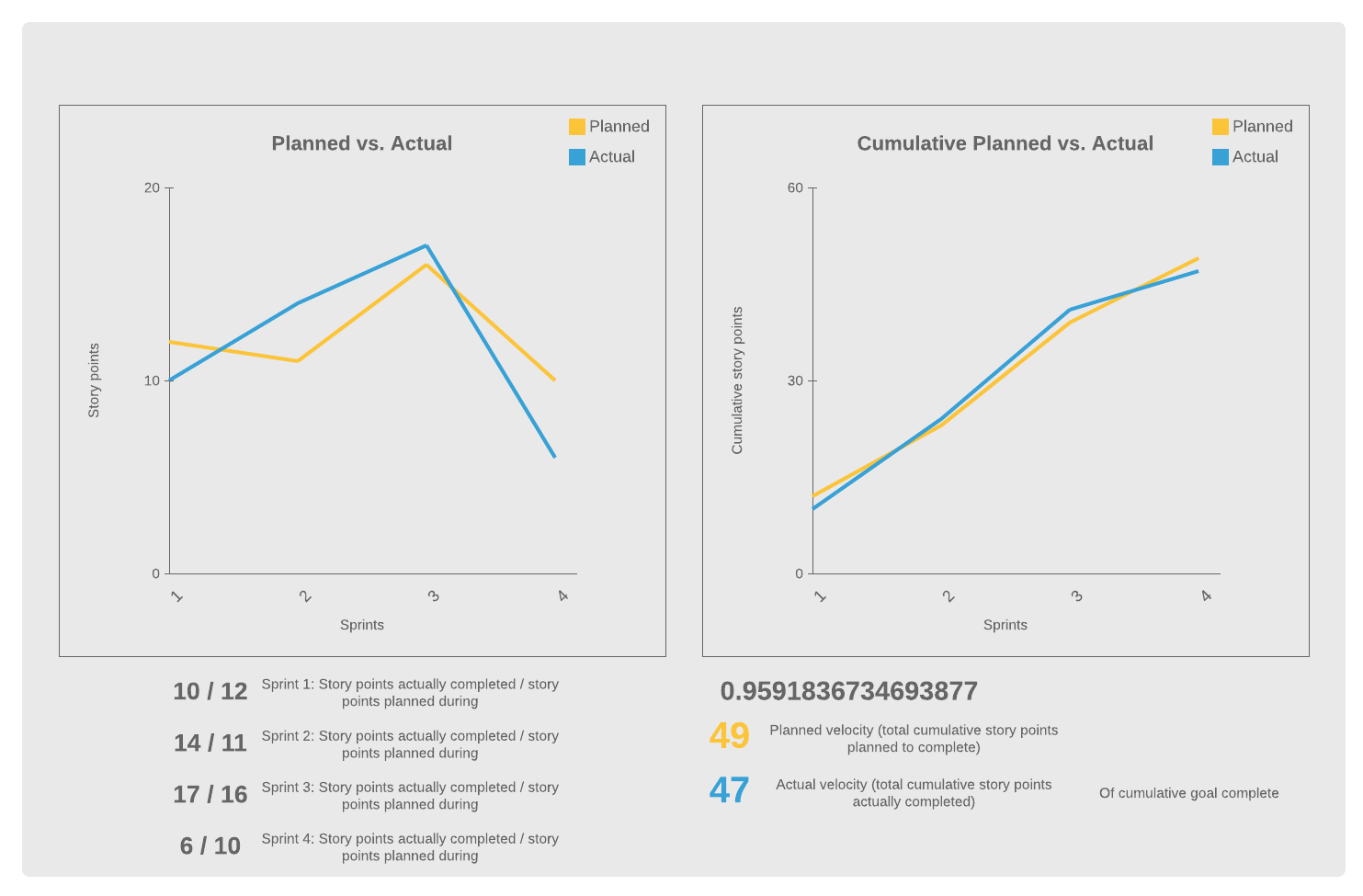

scrum burndown chart
Planned and actual velocity burndown chart example (Click on image to modify online)

Advantages of using a burndown chart in Agile

  • Creates a visual, easy-to-digest point of reference. People generally grasp and retain information better when it is presented visually—the sprint burndown chart should be large and placed prominently where everybody can refer to it as needed.
  • Improves transparency. Displaying the chart where everybody can see it encourages teams to constantly evaluate performance and update estimates of work to be done.
  • Reduces risk. Because the burndown chart gives the team daily feedback about the schedule, actual work, and estimated work, the team can respond to issues and quickly make adjustments before they become problems.
  • Saves time. Tracking progress visually is faster and easier than looking through email and other documents to figure out the current status of the project. Plus, if you have linked your burndown chart to real-time data, it’s also simple to update.

Disadvantages of using a burndown chart in Agile

  • Doesn’t tell the whole story. The burndown chart is somewhat limiting because it is hard to determine if changes are the result of story points being added or subtracted or due to backlog items being completed.
  • Depends on accurate data. The actual effort line will never slope exactly along the ideal effort line. When the actual effort line falls below or above the ideal effort line, does it mean that the team is ahead or behind schedule? Or, does it mean that the team overestimated or underestimated the amount of work to be done?
    If the team regularly overestimates the time requirements, the team will always appear to be ahead of schedule, which could lead to exaggerated expectations.
  • Does not reflect how close work is to being completed. The chart shows you current progress and remaining work, but it does not show you how close the team is to completing the work.
  • Doesn’t account for backlog items. The burndown chart does not indicate which backlog items have been completed. While the chart does show that the team is making progress, it doesn’t show that progress is being made on the right tasks.

Sprint burndown charts provide Scrum teams with the information they need to be organized, self-managed, and motivated to reach a common goal. With Lucidchart, you can create these visuals easily from your data and even include them within popular Agile software such as Jira to provide transparency and better communication across teams.
